Freshly paved asphalt driveway leading to a suburban home
Driveways

Asphalt or concrete. Built on the right base.

A driveway is a structure, not a finish. We engineer the sub-grade and base first, then place the surface — whether that's hot-mix asphalt or poured concrete. Done right, your driveway outlives the next roof.

Recent project

Full asphalt driveway replacement + textured concrete patio.

Tear-out of the original worn drive, re-graded sub-grade, fresh aggregate base, and a clean two-lift hot-mix asphalt pour with hand-tamped beveled edges. While the crew was on-site, we also poured a basic textured concrete patio in the back — one mobilization, two finished surfaces.

Original aged asphalt driveway before replacement, pink layout paint marking the new apron
Before — layout staked, old surface ready for tear-out.

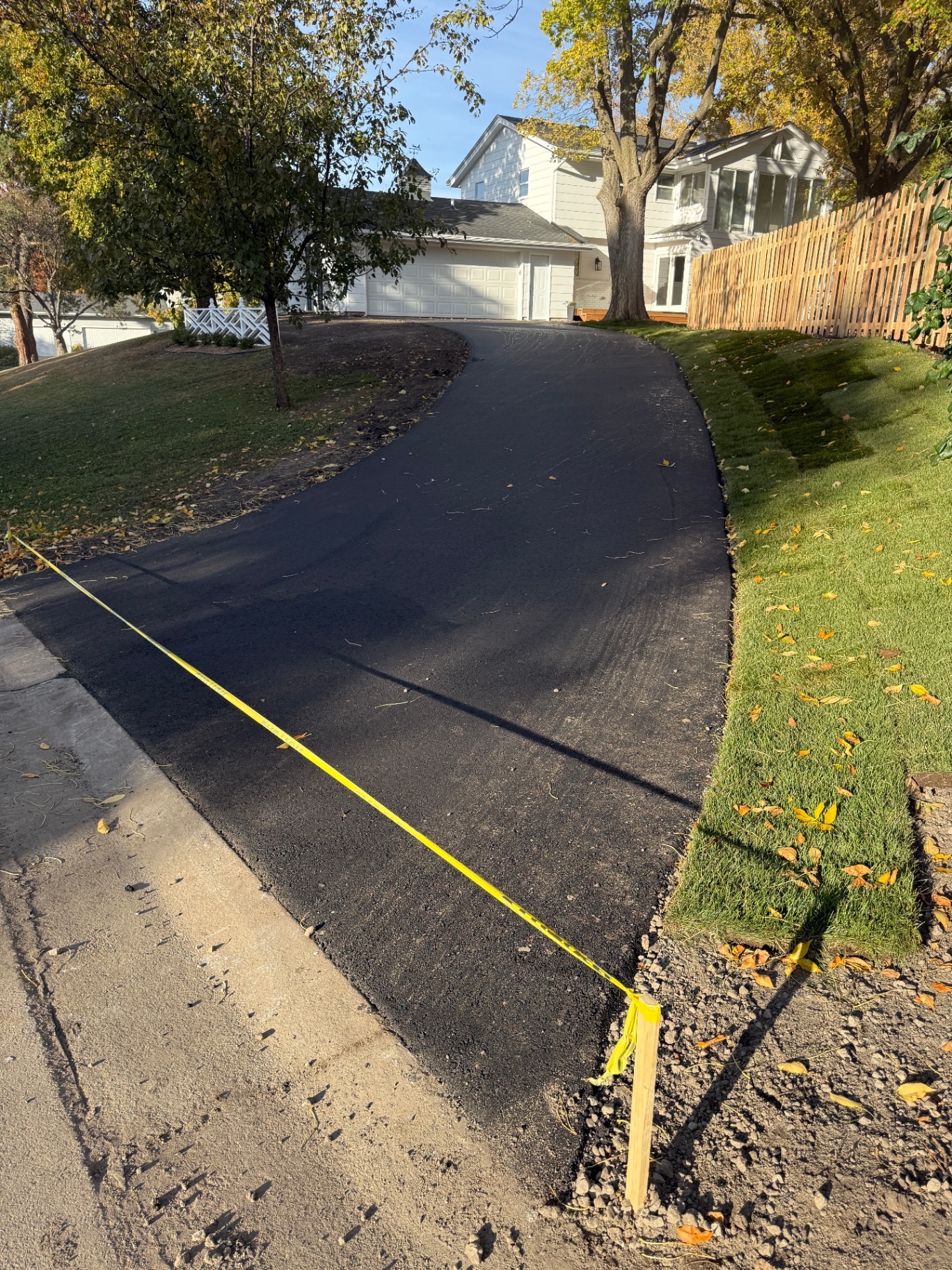

Freshly paved asphalt driveway curving up to a two-car garage with fresh sod along both edges
After — new two-lift asphalt with re-laid sod and clean edges.

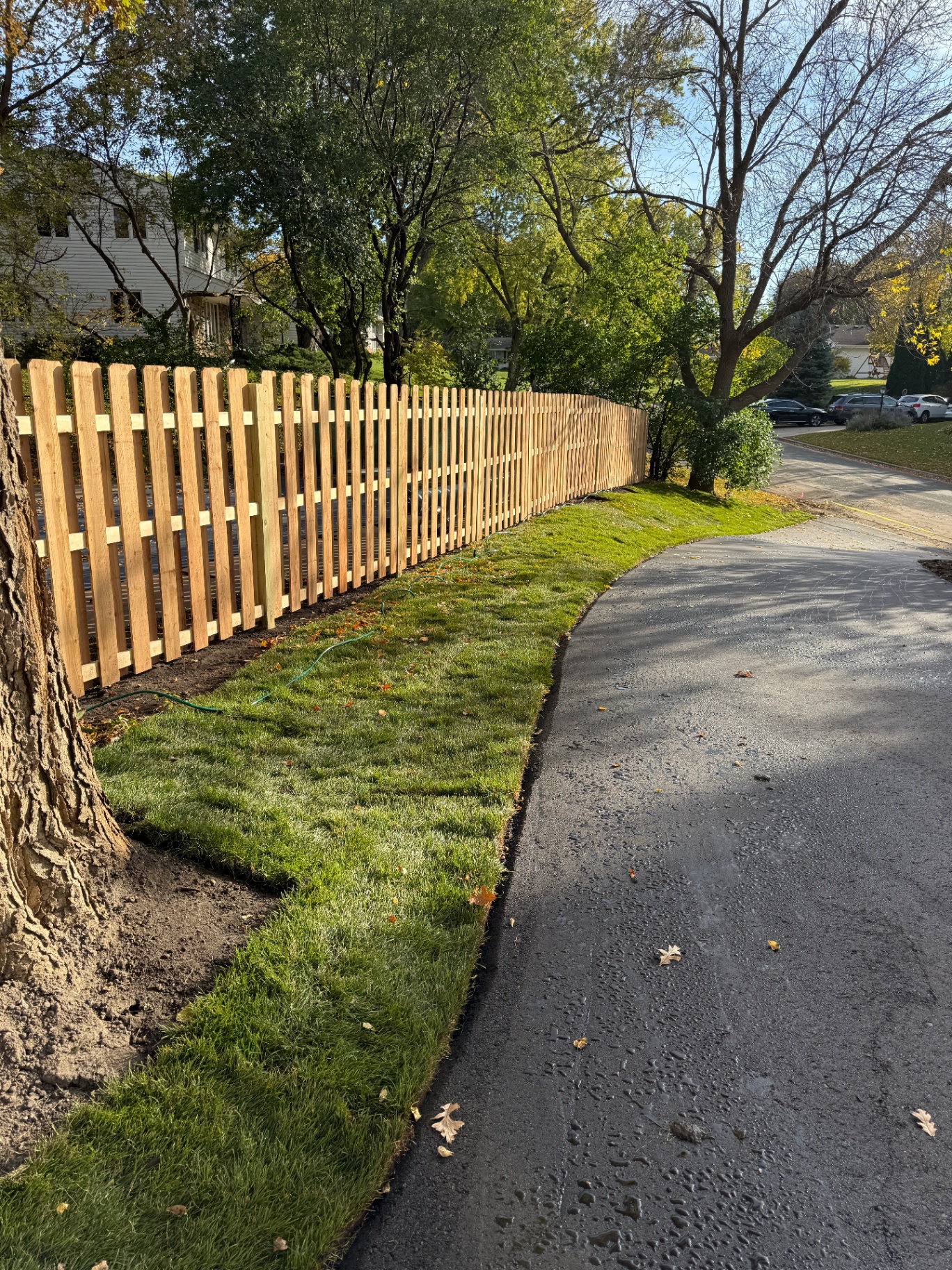

New asphalt driveway with fresh sod and new cedar picket fence along the property line
Edge detail — drive tied into fresh sod along the new property-line fence.

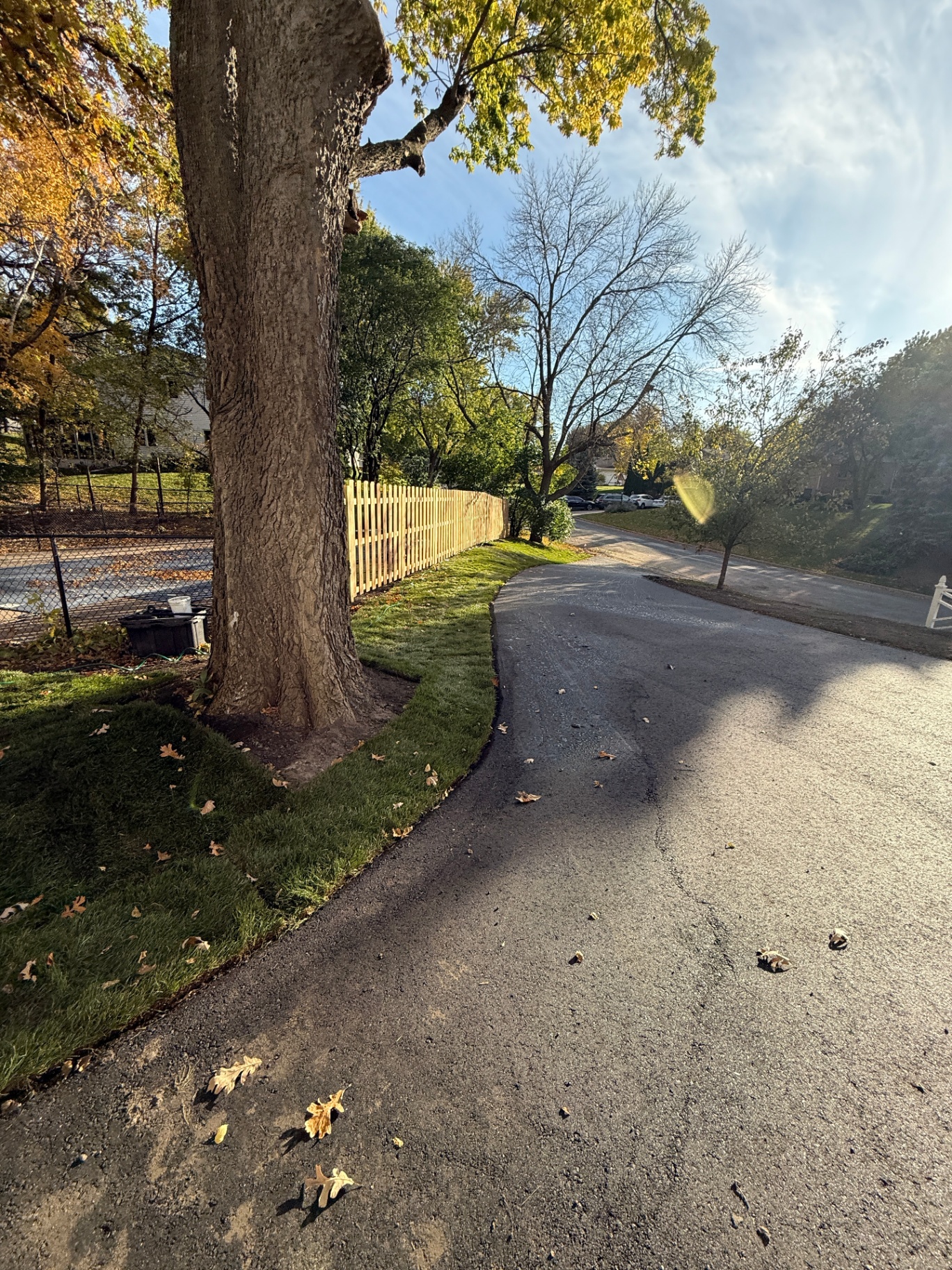

Sweeping curve of new asphalt driveway hugging a mature tree with fresh sod and mulch
Curve work — graded around the existing tree without damaging the root flare.

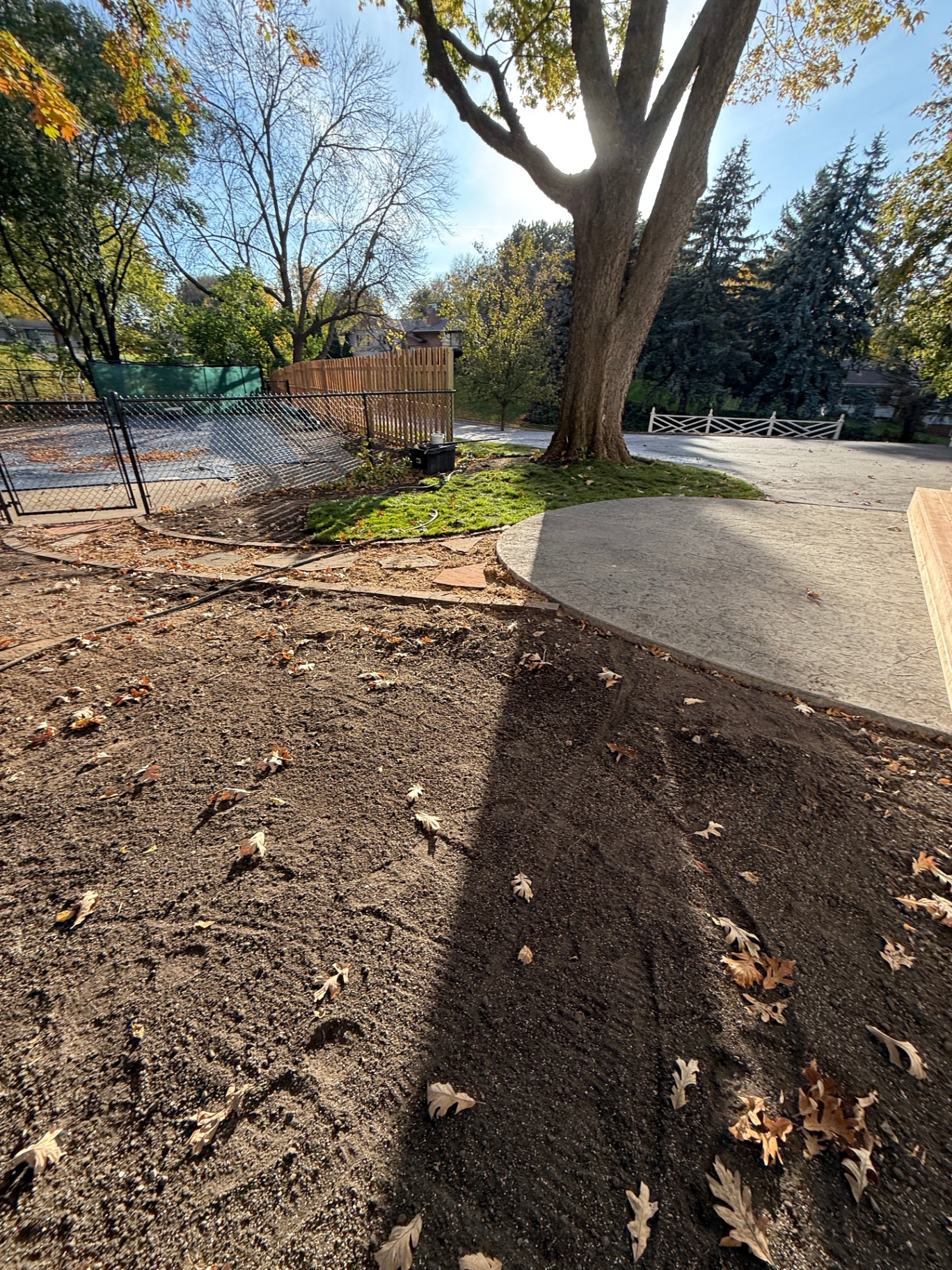

Textured concrete patio with broom-finish edge poured alongside the new asphalt driveway
Same project, second surface

Basic textured concrete patio

A broom-finish textured concrete patio poured at the back of the property as part of the same mobilization. Same engineered base approach as the driveway — proper sub-grade, compacted Class 5, 4,000 PSI air-entrained mix, control joints cut within 24 hours, and a penetrating sealer scheduled for 28 days out.

  • Broom texture for grip
  • 4,000 PSI air-entrained mix
  • Control joints ≤ 10' OC
  • Sealed at 28 days
At a glance

Asphalt vs. concrete — what actually matters.

FactorAsphaltConcrete
Up-front costLowerHigher (~40–60% more)
Lifespan in MN/WI15–20 years with seal coating25–40 years
Best forLong runs, sloped sites, budget-consciousHeavy vehicles, decorative finishes, low-maintenance
Cure / open to traffic24–48 hours7 days foot, 14 days vehicle
MaintenanceSeal coat every 3–5 years, crack fillRe-seal every 3–5 years, joint maintenance
Cold-climate notesFlexes with frost, easy to patchRigid — needs proper joints + sealer against road salt
Pavement

Asphalt driveways

Hot-mix asphalt is the workhorse of Upper Midwest driveways: it flexes with frost cycles, patches easily, and goes in fast. Done right, with a real base and proper compaction, a residential asphalt driveway will give you 15–20 years before it needs more than seal coating.

Site evaluation & layout

We measure the run, confirm slope and drainage, and stake the final width and edge lines. If an old driveway is being replaced, we plan the demo and disposal at the same time.

Excavation & engineered base

We excavate to depth, install woven geotextile where soils are soft, and lay 6–8" of compacted Class 5 aggregate base. The base is what makes a driveway last — not the surface.

Asphalt placement

Two-lift hot-mix asphalt — a coarse binder course followed by a finer wear course — totaling 3–4" compacted thickness for residential driveways. Edges are hand-tamped at a 45° bevel.

Drainage & tie-ins

Positive slope away from the home, a clean apron tie-in at the street, and swales or trench drains added where the grade requires it. Water is the #1 killer of asphalt.

Our asphalt spec

  • 6–8" compacted Class 5 aggregate base
  • 3–4" two-lift hot-mix asphalt
  • Hand-tamped 45° beveled edges
  • Minimum 1% slope for drainage
  • Cure 24–48 hours before driving
  • First seal coat recommended at 12 months
Concrete

Concrete driveways

A properly designed concrete driveway is a 30-year structure. The trade-offs are higher up-front cost and a longer cure time, but in return you get a rigid slab that handles heavy vehicles, takes decorative finishes, and shrugs off day-to-day wear. The keys are mix design, reinforcement placement, and joint layout.

Layout, forms & sub-grade

We form the slab to your final dimensions, verify slope, and prep a uniformly compacted sub-grade. Soft or organic soils are excavated and replaced with engineered fill.

Base, vapor & reinforcement

4–6" of compacted Class 5 base, then #4 rebar on chairs in a grid (or fiber-mesh + rebar around the perimeter), positioned in the upper third of the slab.

Pour, screed & finish

4,000+ PSI air-entrained mix poured at 5" thickness (6" where vehicles turn or park heavy). Screed, bull-float, edge, broom finish for grip, then jointed.

Joints, cure & seal

Control joints cut within 24 hours at no more than 10' on center. Cure compound applied same-day. Penetrating sealer at 28 days to lock out water and de-icing salts.

Our concrete spec

  • 4–6" compacted Class 5 aggregate base
  • 5–6" slab thickness
  • 4,000+ PSI air-entrained concrete
  • #4 rebar grid or fiber + perimeter rebar
  • Control joints at ≤ 10' on center
  • Penetrating sealer at 28 days, then every 3–5 years
How long it takes

Typical project timeline

  1. 01
    Estimate

    On-site measure and written proposal within 48 hours.

  2. 02
    Demo & prep

    1–2 days. Old surface removed, sub-grade cut to depth.

  3. 03
    Base + pour/pave

    1–2 days. Aggregate placed and compacted, then surface installed.

  4. 04
    Cure & open

    Asphalt: 24–48 hrs. Concrete: 7 days foot, 14 days vehicle.

Most driveways are scheduled May through October in MN & WI for ideal cure conditions.

Ready to pave?

Let's price your driveway.

We'll measure, talk through asphalt vs. concrete for your site, and send a line-item quote with materials and timeline.

Request your estimate
